Self Storage Construction Checklist: From Planning to Steel Erection

1-PagersFeatured
steelco buildings self storage checklist thumbnail
Plan your self storage building project effectively with our comprehensive checklist. Stay organized and stress-free throughout.

Download Checklist

Successful self storage construction begins long before crews arrive on site.

Before steel is ordered or concrete is poured, the developer must confirm that the market can support the facility, the property can be developed as intended, the financing works, and the local approval path is realistic. Those early decisions shape the unit mix, building layout, total construction cost, project schedule, and long-term operating performance.

That is why an effective self storage construction checklist should cover more than field activities. It should guide the project from early feasibility through site planning, permitting, foundations, steel delivery, and erection.

The process is not always perfectly linear. Civil engineering may reveal a site constraint that changes the layout. A lender may require updates to the financial model. Permit comments may affect the building design. However, approaching the project in the right general sequence can reduce redesigns, control unnecessary costs, and help the entire team work toward the same opening-day goal.

This guide walks through the major stages of planning and building a self storage facility, along with the decisions that deserve attention before the project moves forward.

Table of Contents
1. Confirm That the Market Supports the Project
2. Put the Right Property Under Contract
3. Develop a Preliminary Site Plan
4. Build a Complete Self Storage Construction Budget
5. Begin Permitting Early
6. Finalize the Building Design
7. Begin Sitework and Build the Pad
8. Coordinate Underground Work Before Concrete
9. Coordinate Foundations and Slab Preparation
10. Pour the Slab With the Building in Mind
11. Prepare for Steel Delivery
12. Begin Steel Erection
Important Decisions That Can Affect Cost and Schedule
Condensed Self Storage Construction Checklist
Frequently Asked Questions
A Better Project Starts Before Construction

1. Confirm That the Market Supports the Project

The first question should not be, “How much will the building cost?”

It should be, “Does this market need the facility we are considering?”

A professional market study should evaluate nearby competitors, current occupancy, asking rents, population growth, housing trends, planned developments, and the amount of new storage supply entering the area. It should also help determine which unit types and sizes are most likely to perform.

Depending on the location, the recommended mix may include:

  • Drive-up storage units
  • Climate-controlled interior units
  • Larger contractor or business units
  • Boat and RV storage
  • Covered vehicle storage
  • A combination of traditional and specialty storage

A facility near dense apartment communities may require more small climate-controlled units. A suburban property may generate stronger demand for drive-up storage. Sites near lakes, campgrounds, or rapidly growing residential areas may support boat and RV storage.

Start with a market study so you understand local demand, competing facilities, achievable rental rates, and the unit mix most likely to perform before advancing the design. The project checklist similarly begins with market demand, competition, and unit-mix planning because these decisions affect nearly every stage that follows.

Let the unit mix shape the facility

The unit mix is not only an operating decision. It directly affects the building.

A climate-controlled facility requires insulation, mechanical systems, interior corridors, controlled entrances, and a different approach to fire protection than a basic drive-up facility.

Large vehicle-storage units may require taller eave heights, wider doors, and more turning room. Smaller interior units can increase rentable efficiency but may also add partitions, hallways, lighting, and ventilation requirements.

The facility should therefore be designed around how customers will use it—not simply around how many buildings appear to fit on the property.

Early feasibility stages for a self storage construction project.

2. Put the Right Property Under Contract

A strong market does not automatically make every property suitable for self storage.

Before purchasing land, confirm that self storage is permitted and that the property can physically support the intended development. Ideally, the site should be placed under contract with enough due-diligence time to investigate zoning, utilities, access, drainage, environmental conditions, and soils.

Key questions include:

  • Is self storage allowed under the current zoning?
  • Will the project require rezoning or a special-use permit?
  • Are water, sewer, electricity, and fire service available?
  • Are there easements, wetlands, flood zones, or environmental restrictions?
  • Can customers, delivery trucks, and emergency vehicles enter safely?
  • How much usable land remains after setbacks, buffers, and stormwater requirements?
  • Is there space for a future phase?

A site can appear large enough until the civil engineer accounts for detention areas, fire lanes, landscaping, utility easements, setbacks, and road improvements. The amount of truly developable land may be significantly smaller than the gross acreage suggests.

Before advancing the project, confirm that the property is properly zoned or that there is a clear path toward approval. This is also the right time to involve local civil, geotechnical, surveying, and feasibility professionals who understand the site and jurisdiction.

Build the local project team early

Most self storage developments require several specialized professionals.

The civil engineer develops the grading, drainage, utility, erosion-control, access, and stormwater plans. A geotechnical engineer evaluates the soil and recommends how the building pad and foundations should be prepared. A surveyor confirms property boundaries, easements, and site elevations.

Depending on the project, the team may also include an architect, land-use attorney, environmental consultant, traffic engineer, fire-protection designer, general contractor, and metal building supplier.

Bringing these professionals into the project early is generally more efficient than discovering a major site or approval issue after the design has already progressed.

3. Develop a Preliminary Site Plan

Once the property appears viable, the project team can begin developing a conceptual layout.

The initial plan should account for building placement, customer circulation, fire access, entrances, stormwater areas, utilities, parking, office or kiosk space, security gates, landscaping, and future expansion.

For drive-up self storage, vehicle movement is especially important. Customers need enough space to approach their units, park, unload, turn around, and exit without blocking traffic.

For climate-controlled buildings, the design may focus more heavily on rentable efficiency, corridor placement, entrances, elevators, HVAC zones, and fire-code requirements.

The preliminary plan should also be reviewed by the building supplier. A layout may look efficient from a land-planning perspective while using building widths, roof conditions, or bay spacing that create unnecessary structural costs.

Have the supplier review the initial layout early. This can help establish preliminary building costs, identify inefficient dimensions or framing conditions, and uncover opportunities to save time or reduce avoidable expense.

Small adjustments are much easier to make during conceptual planning than after civil plans, permit drawings, and structural engineering are substantially complete.

4. Build a Complete Self Storage Construction Budget

The steel building package is only one part of the total development cost.

A realistic budget should include the full project, from land acquisition through opening day. Depending on the facility, major cost categories may include:

  • Land, closing costs, and due diligence
  • Civil engineering, architecture, and surveying
  • Permits, impact fees, and utility fees
  • Clearing, grading, drainage, and stormwater work
  • Utility extensions and connections
  • Foundations and concrete slabs
  • Steel building materials and erection
  • Storage partitions and roll-up doors
  • Electrical, lighting, security, and access control
  • HVAC, insulation, and interior finishes
  • Fire protection
  • Paving, fencing, landscaping, and signage
  • Construction interest and loan fees
  • Pre-opening expenses and contingency

Climate-controlled facilities may require substantial mechanical, insulation, fire-protection, and interior-construction costs. Properties with poor soils, major elevation changes, or limited utility access may also cost much more to develop than a level, construction-ready site.

Confirm financing and available equity

Many projects require meaningful owner or investor equity.

As an early planning benchmark, developers may need approximately 25% to 30% of the total project cost in cash or investor equity, although actual requirements vary by lender, borrower, market, and financing structure.

The financial model should also show that projected cash flow can comfortably cover annual debt payments. Preliminary lender feedback is valuable before the project advances too far because financing assumptions may affect the facility size, phasing strategy, and overall design.

Leave room for the unexpected

Self storage construction budgets often change as engineering becomes more detailed.

Poor soils may require undercutting or additional fill. A utility connection may be farther away than expected. The jurisdiction may require road improvements, a larger stormwater system, upgraded fire service, or additional landscaping.

Material pricing, interest rates, and contractor costs may also change between the initial concept and the start of construction.

A meaningful contingency gives the project room to absorb these issues without immediately creating a financing shortfall.

5. Begin Permitting Early

Permitting is often one of the longest and least predictable stages of self storage development.

A project may require review by planning and zoning, the building department, public works, utility providers, the fire marshal, environmental agencies, and state or local transportation departments.

Projects requiring rezoning, conditional-use approval, or a public hearing can take even longer.

Start the permitting process early. Civil engineering generally needs to advance first, and approvals may take anywhere from several weeks to many months depending on local zoning, stormwater, utility, and building-review requirements.

A typical permit package may include:

  • Civil construction drawings
  • Grading and drainage plans
  • Utility and erosion-control plans
  • Architectural elevations
  • Structural building drawings
  • Foundation plans
  • Landscape plans
  • Fire-access documents
  • Lighting or photometric plans

Developers should also confirm whether an architect is required. Some straightforward projects may be permitted with supplier drawings supported by locally prepared civil and foundation plans. Other jurisdictions or building types may require an architect to coordinate the complete permit set.

6. Finalize the Building Design

Once the site plan, financing strategy, and approval path are sufficiently developed, the metal building scope can be finalized.

This is the point to confirm:

  • Building width, length, and eave height
  • Roof slope and drainage direction
  • Bay spacing and framing configuration
  • Local building code and structural loads
  • Unit and corridor layout
  • Door and framed-opening locations
  • Roof and wall panel specifications
  • Insulation requirements
  • Gutters and downspouts
  • Canopies, entrances, and architectural features
  • Office or kiosk space
  • Future expansion plans

The building design must coordinate with both the civil plan and the operating concept.

Roof drainage should not discharge into customer entrances or create ponding in drive aisles. Structural columns and bracing should not interfere with unit doors. Finished-floor elevations need to work with the site drainage. Plumbing, electrical, and security pathways should be planned before the slab is poured.

If the facility may be expanded in the future, that should be discussed during the original design. Future building phases, utilities, access, drainage, and structural endwalls are easier to accommodate when they are included in the initial plan.

Download Checklist

Pre-construction roadmap for a self storage development.

7. Begin Sitework and Build the Pad

After the necessary approvals are in place and the building package is moving forward, construction typically begins with the site.

The contractor may start with clearing, erosion control, rough grading, stormwater infrastructure, utility installation, and access-road preparation.

The building pad should be constructed according to the civil plans and geotechnical recommendations. Fill is generally placed and compacted in controlled lifts, with testing used to confirm that the required density has been achieved.

This stage may not be as visually dramatic as steel erection, but it has a major effect on the finished project. Poorly prepared soils can contribute to slab cracking, settlement, drainage problems, and foundation movement.

Compaction tests and inspection results should be documented as the work progresses.

8. Coordinate Underground Work Before Concrete

All required below-slab systems should be coordinated before reinforcing steel and concrete are completed.

Depending on the facility, underground work may include:

  • Plumbing and sanitary connections
  • Electrical conduits
  • Site-lighting sleeves
  • Water and fire-service lines
  • Security and gate-control conduits
  • Data and communication pathways
  • Roof-drain or stormwater connections

Electrical conduits, site-lighting sleeves, plumbing stubs, security pathways, and other below-slab systems are far easier and less expensive to install before the slab is poured.

Before concrete work advances, compare the civil, structural, electrical, plumbing, security, and building plans. A missed conduit or misplaced plumbing stub may require cutting and repairing the slab later.

9. Coordinate Foundations and Slab Preparation

The foundation is the base for the entire self-storage facility and should be designed to match the building system, structural loads, and installation requirements provided by the building manufacturer.

Once the building package is finalized, the foundation engineer can use the supplier’s structural reactions, column locations, and connection details to complete the project-specific foundation design.

Whether the building uses cast-in-place anchor bolts or post-installed anchors, accurate slab layout and concrete placement are essential to a smooth installation.

Before placing concrete, verify:

  • Building gridlines and column centerlines
  • Foundation and slab dimensions
  • Finished floor elevations
  • Door openings and threshold elevations
  • Required embeds or anchor locations (if applicable)
  • Underground utilities and sleeves

A pre-pour review involving the concrete contractor, superintendent, erector, and surveyor can identify potential issues before they become costly field corrections.

Required inspections may include footings, reinforcing steel, vapor barriers, underground mechanical, electrical, and plumbing systems, and any required embedded items. Confirm the local inspection sequence in advance to avoid unnecessary delays.

10. Pour the Slab With the Building in Mind

Because many self-storage facilities utilize post-installed anchors rather than cast-in-place anchor bolts, slab quality and dimensional accuracy become especially important. The concrete should be placed and finished in accordance with the building manufacturer’s tolerances so anchors can be installed accurately after the slab has cured.

The slab design should also reflect how the facility will operate.

Drive-up storage requires careful attention to door thresholds, pavement transitions, and drainage so water moves away from individual units. Climate-controlled facilities may place greater emphasis on vapor control, floor flatness, interior wall layouts, and mechanical system coordination.

Control joints should be installed as specified, and the slab should be allowed to cure properly before anchor installation and steel erection begin.

A properly prepared slab helps the erection crew install framing efficiently, maintain alignment, and minimize field adjustments throughout the remainder of construction.

11. Prepare for Steel Delivery

Before the steel arrives, the site must be ready to receive it.

The contractor should provide stable truck access, adequate turning space, a level laydown area, unloading equipment, qualified operators, and enough labor to unload safely.

Once production and transportation are scheduled, the building supplier should issue a confirmed delivery date so the contractor can coordinate access, labor, equipment, and material staging.

Materials should be inventoried during unloading. Visible damage should be photographed, and missing or damaged components should be reported promptly.

Waiting until the erection crew needs a particular piece can turn a manageable shipping issue into a schedule delay.

12. Begin Steel Erection

Once the foundation has reached the required strength and the building materials are on site, erection can begin.

The typical sequence starts with the primary rigid frames. Secondary framing, bracing, roof panels, wall panels, trim, gutters, downspouts, framed openings, and accessories follow.

After the building shell is in place, work can continue on interior storage partitions, roll-up doors, HVAC, electrical systems, lighting, fire protection, security cameras, access control, paving, fencing, landscaping, and signage.

The exact sequence varies by project, and several trades may overlap. Strong scheduling and communication become especially important as the project moves toward final inspections and opening day.

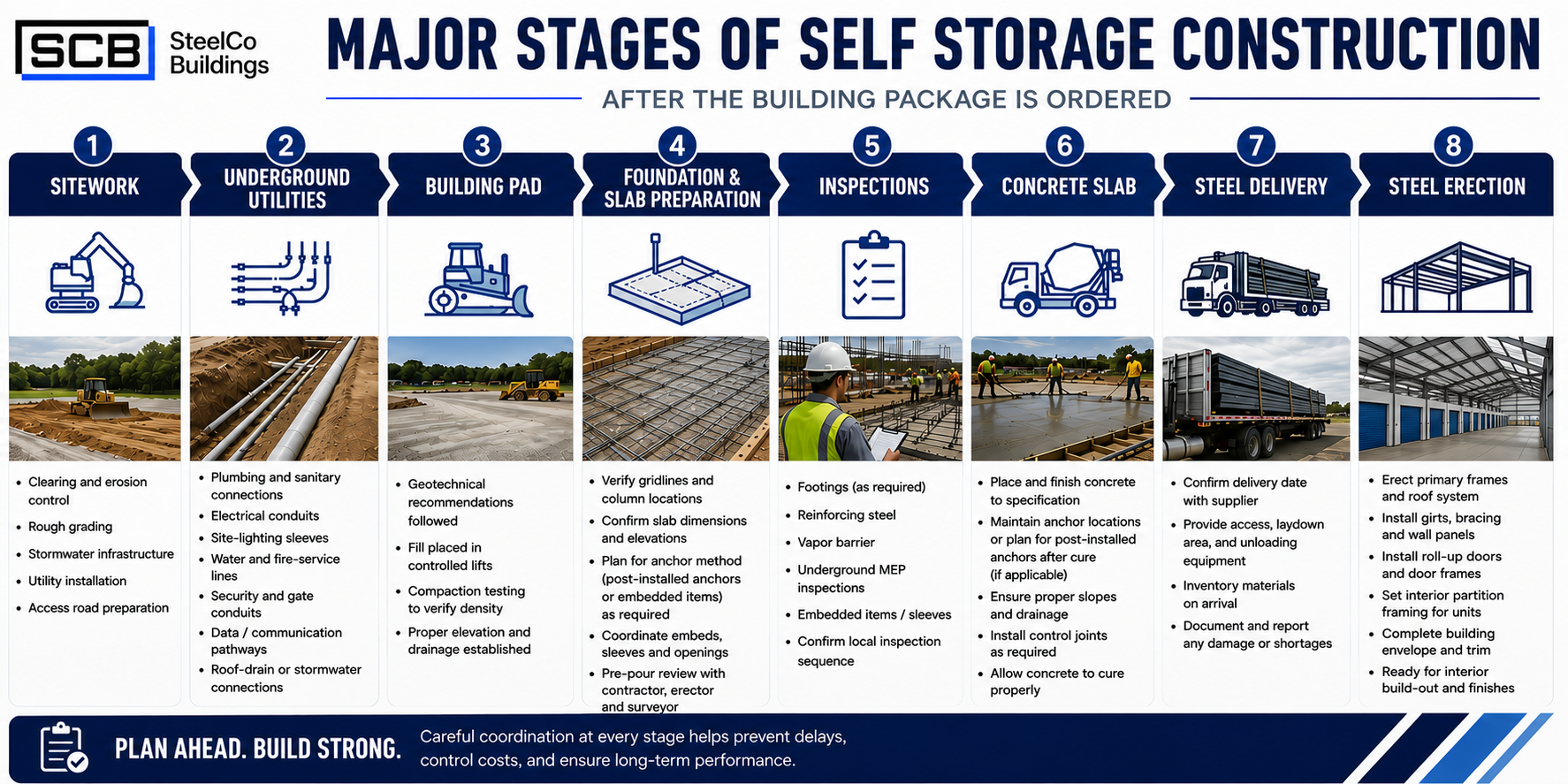

Major stages of self storage construction after the building package is ordered.

Important Decisions That Can Affect Cost and Schedule

Several issues deserve attention even though they do not fit neatly into a single construction phase.

Staffed or remotely managed?

A staffed facility may require a finished leasing office, restroom, additional parking, HVAC, and customer-service space.

A remote facility may rely on online leasing, automated access control, kiosks, and off-site management. Depending on the facility, technology, staffing plan, and local wages, the combined savings from reduced office buildout and payroll could be substantial. The project checklist uses approximately $80,000 to $120,000 as a planning example, although actual savings will vary widely.

This decision should be made early because it affects the site plan, utilities, building footprint, security systems, and operating budget.

How long will the project take?

The physical construction period is only one part of the development schedule.

From land acquisition to opening day, many self storage projects take approximately 18 to 24 months. Permitting alone may consume six to nine months when rezoning, special-use approval, public hearings, or more complex civil reviews are involved.

Actual schedules depend on the jurisdiction, site conditions, financing, design complexity, weather, material lead times, and contractor availability.

Will the site and building manage water properly?

Roof slope, gutters, downspouts, grading, and stormwater infrastructure need to work together.

Poor drainage can create standing water, premature coating deterioration, foundation problems, and water intrusion around storage units.

Appropriate roof slopes, durable or hail-rated panel systems, and well-designed drainage can help reduce storm damage, water-related problems, and long-term maintenance costs. Some insurers may also view resilient materials and non-combustible construction favorably, although potential premium savings should be confirmed directly with the carrier.

Four factors that can affect self storage construction costs and schedules.

Condensed Self Storage Construction Checklist

Download Checklist

Use this summary to confirm that the major milestones are being addressed.

Feasibility and site planning

  • Complete the market study and recommended unit mix.
  • Secure the property with an adequate due-diligence period.
  • Confirm zoning, access, utilities, and development restrictions.
  • Hire the appropriate local engineering and consulting professionals.
  • Develop a preliminary site and building layout.

Financing, design, and approvals

  • Build a complete development budget.
  • Confirm available equity and preliminary lender terms.
  • Begin civil engineering and permitting early.
  • Coordinate architectural, structural, and foundation requirements.
  • Finalize the building dimensions, specifications, and pricing.
  • Approve the steel package and project schedule.

Construction and delivery

  • Complete sitework, grading, stormwater, and utilities.
  • Construct and test the building pad.
  • Install underground conduits and plumbing.
  • Set reinforcing steel and anchor-bolt templates.
  • Pass required inspections.
  • Pour the foundation and slab.
  • Prepare truck access and the material laydown area.
  • Receive, inspect, and inventory the building package.
  • Begin erection and complete the building envelope.

Frequently Asked Questions

How long does self storage construction take?

The physical construction period may be shorter than the full development timeline. From land acquisition through opening day, a project may take approximately 18 to 24 months once due diligence, civil design, financing, permitting, construction, and final inspections are included.

How long does permitting take for a self storage facility?

Permitting may take several weeks or many months. Projects requiring rezoning, special-use approval, public hearings, significant stormwater work, or utility improvements usually take longer than projects already allowed by right.

How much equity is needed to build a self storage facility?

A reasonable early planning benchmark is approximately 25% to 30% of the total project cost through owner cash or investor equity. The final requirement will depend on the lender, borrower experience, financing structure, market, and projected facility performance. Learn more about self storage construction costs here.

When should the steel building package be ordered?

The building package should generally be ordered after the site layout, major building dimensions, permitting strategy, and financing path are sufficiently established. Ordering too early can create costly revisions, while ordering too late can delay foundations and erection.

Should I build drive-up or climate-controlled storage?

The answer should come from the market study and operating strategy. Drive-up storage may offer simpler construction and convenient vehicle access. Climate-controlled storage may support higher rents but requires insulation, HVAC, corridors, controlled access, and more interior construction. Many developments include a mix of both.

Why should the building supplier be involved early?

Early involvement allows the supplier to review building widths, bay spacing, roof conditions, framed openings, and expansion plans before the design becomes difficult to change. This can improve constructability and help the civil engineer, architect, contractor, and structural supplier work from a coordinated concept.

What happens after the steel package is delivered?

The shipment is unloaded and inventoried before erection begins. Crews typically erect the primary frames first, followed by secondary framing, bracing, roof panels, wall panels, trim, gutters, downspouts, and accessories. Interior partitions, doors, electrical work, HVAC, security, and site improvements follow.

Can a self storage facility be expanded later?

Yes. Many self storage developments are constructed in phases. Future expansion should be considered during the original planning process so access, utilities, drainage, foundations, and structural endwalls can support the long-term plan.

What are the most common causes of self storage construction delays?

Common causes include zoning and permitting delays, civil-plan revisions, utility coordination, poor soils, foundation or anchor-bolt errors, financing delays, material lead times, weather, and late design changes. Early coordination and realistic scheduling help reduce these risks.

A Better Project Starts Before Construction

Self storage construction becomes more predictable when feasibility, site planning, financing, permitting, foundations, and steel are treated as parts of one coordinated process.

SteelCo Buildings has shipped more than five million square feet of self storage materials across the United States and brings more than 24 years of self storage experience to the planning and delivery process.

Involving an experienced building supplier early can help owners evaluate initial layouts, establish realistic building costs, coordinate structural requirements, and avoid preventable design changes before work reaches the field.

The steel package matters, but the strongest projects are built on something even more important: a clear plan.

Download Checklist
